Exterior Painting in Boise's North End
Whole-house exterior painting for 80–120-year-old North End homes — EPA RRP lead-safe certified, careful prep on original wood siding and trim, period-correct color schemes, and Historic Preservation Commission color guidance.
Exterior painting in Boise's North End is one of the most consequential maintenance investments a homeowner can make — and one of the most commonly done badly. The original wood siding and trim on pre-1960 North End homes is high-quality old-growth fir or cedar that, properly maintained, can last centuries. But it requires careful prep (scraping, sanding, priming, caulking) before paint, and the federal EPA RRP rule requires lead-safe work practices for any disturbance of pre-1978 paint surfaces. Skipping these steps to save money produces a paint job that fails within 3–5 years instead of lasting 8–12 years. Iron Crest is EPA RRP certified, has painted hundreds of North End exteriors, and brings the prep discipline and color sense these homes require. Where the home is within the North End Historic District boundary, exterior color choices are subject to Historic Preservation Commission guidance for compatibility — we navigate this process as part of every project.
Exterior painting strategy varies by era because the siding type, trim profiles, and original color conventions differ across the North End's housing waves.
1900–1925: Original Craftsman bungalows
Original wood lap siding (typically 7-inch reveal cedar or fir) with painted trim, exposed rafter tails, tapered porch columns, and cedar shingle accents on gables. Original colors were typically deep saturated tones (forest green, deep red, warm brown) with cream or warm-white trim. Painting these homes requires careful surface prep on original wood that's been weathering for a century.
1925–1940: Tudor Revival, Colonial Revival
Tudor: stucco panels with painted decorative half-timbering, often slate-look composite roofing and small-window patterns. Colonial Revival: painted lap siding with formal trim details, sometimes brick veneer accents. Color schemes lean toward formal traditional palettes — earthy greens, warm whites, deep reds, slate grays.
1945–1965: Post-war ranch and minimal traditional
Painted lap siding (often original wood, occasionally aluminum from later updates), simpler trim, brick veneer accents, single-story massing. Color schemes from the era featured pastels and earth tones; modern repaints typically choose more saturated current-taste palettes.
1985–present: Infill and rebuilds
Modern lap siding (Hardie, LP SmartSide, vinyl). Standard exterior painting practices apply with no environmental complications. Faster turnaround than work on older homes.
Exterior painting projects in the North End fall into recognizable shapes based on what's being painted and what level of prep is required.
1. The Whole-House Repaint — comprehensive exterior refresh
Standard scope: power-wash, scrape and sand failing paint, prime bare wood and patches, caulk gaps and cracks, two finish coats of premium exterior paint on body, trim, and accents. EPA RRP-compliant for pre-1978 homes. Color consultation included. Typical timeline depends on home size and prep scope.
Target homes: Any North End home whose exterior is failing or whose color is dated. Permit: no permit required for paint; HPC color review applies for homes in Historic District.
2. The Trim & Accents Repaint — preserved body, refreshed details
Painting only trim, fascia, soffits, exposed rafter tails, porch columns, doors, and decorative elements while leaving the main body siding as-is. Common when body color is fine but trim needs refresh, or when budget doesn't allow whole-house. Highest visual impact per dollar.
Target homes: North End homes where body siding is in good shape but trim and accents need attention. Permit: none.
3. The Color-Change Repaint — comprehensive scheme update
Whole-house repaint that involves changing one or more colors substantially (e.g., from beige to deep green; from white to navy). Requires color-blocking primer or additional finish coats to achieve full color shift. Higher cost than same-color refresh.
Target homes: Homes wanting a substantive aesthetic shift. Permit: none for paint; HPC color review if in Historic District.
4. The Restoration Repaint — heavy prep on long-deferred surfaces
Painting a North End home that hasn't been properly painted in 15–25+ years. Substantial scraping required (often 30–60 hours of scraping labor on a typical bungalow), wood replacement on rotted areas, extensive priming and caulking. Lead-safe practices throughout. Result: a properly prepped exterior that should hold 8–12 years.
Target homes: Homes with significant deferred maintenance — peeling paint, exposed wood, soft spots. Permit: none for paint, but rotted-wood replacement may require building permit.
5. The Spot Repaint + Repair — focused damage and refresh
Targeted prep and painting on specific elevations or features (e.g., south-facing wall that's weathered faster than others, or porch that needs full refresh while rest of house is fine). Includes any required wood repair on the focused area. Lower cost than whole-house when only specific areas need attention.
Target homes: Homes with localized failure on specific exposures. Permit: none.

The North End spans roughly two square miles with distinct sub-neighborhoods, each with its own remodeling personality.
13th Street & Hyde Park
The cultural and commercial heart of the North End — boutique shops and restaurants along 13th between Brumback and Eastman, with the densest concentration of original Craftsman bungalows on the surrounding blocks. Lots are tight (typically 50' frontage), alley access is common, and the neighborhood is heavily walked. Most homes here are 1905–1925 Craftsman.
Camel's Back & Heron Streets
The streets immediately around Camel's Back Park, climbing slightly into the lower foothills. Mostly Craftsman bungalows with some Tudor Revival mixed in. Lots get larger toward the park edge, and some homes back to the Foothills Reserve with significant trees. Project budgets here tend to be higher — these are some of the most coveted blocks in the city.
Harrison Boulevard corridor
The grand divided boulevard running south-to-north through the heart of the North End, lined with the neighborhood's largest historic homes. Tudor Revival, Colonial Revival, and a few notable Prairie-style houses sit on deep lots with mature plantings. Projects here lean toward sympathetic upgrade rather than reconfiguration — these homes already have generous floor plans.
Fort Boise & Capitol-area North End
The streets around Fort Boise Park and stretching toward the State Capitol grounds — a mix of original Craftsman bungalows, larger 1920s and 1930s homes, and a higher proportion of post-war infill. Lots vary widely. Project scopes span the full range depending on house age and homeowner intent.
North of Hill Road / new infill
The northern fringe of the historic North End, where construction continued through the 1950s and where modern infill has been most active. Newer (1945–present), larger, less constrained by historic-district considerations. Projects here look more like SE Boise or Harris Ranch in scope and material strategy.
Lower-numbered streets (3rd–9th)
The streets between the State Capitol grounds and Fort Boise — traditionally a more working-class section of the North End, with a mix of smaller Craftsman bungalows, post-war houses, and some converted multi-family. Increasingly being renovated as North End demand pushes outward from the 13th Street core. Excellent value if you can find an unrenovated home here.
Exterior painting in pre-1978 North End homes runs 30–50% above what the same scope would cost in newer Boise construction, driven by EPA RRP-required practices, century-old wood substrate prep, and the careful approach these original surfaces deserve.
North End exterior painting ranges
Spot repaint (specific elevation or feature, focused prep + paint): $3,500–$8,500 / 1–3 weeks
Trim & accents only (all trim, fascia, soffits, doors, columns; body preserved): $5,500–$11,000 / 1–2 weeks
Standard whole-house (comprehensive prep + 2 finish coats body and trim, similar color): $12,000–$22,000 / 2–4 weeks
Color-change whole-house (comprehensive scheme update with color-blocking primer): $14,000–$26,000 / 3–5 weeks
Restoration repaint (long-deferred home requiring extensive scraping, wood repair, lead remediation): $22,000–$32,000 / 4–6 weeks
Pricing assumes EPA RRP lead-safe practices for any pre-1978 home, premium exterior paint (Benjamin Moore Aura Exterior, Sherwin Williams Duration, or equivalent), comprehensive surface prep including scraping/sanding/priming/caulking, two finish coats on body and trim, careful protection of plantings and adjacent surfaces, and a 7-year workmanship warranty on properly prepped surfaces. Lift or scaffolding rental for two-story homes is included.
The North End Historic District boundary covers most — but not all — of the North End. The district is administered by the City of Boise Historic Preservation Commission, which reviews exterior modifications within the district boundary. Interior work, including comprehensive remodels, is exempt from Historic Preservation review. This is the single most important permitting fact to internalize: your interior work doesn't need historic review, regardless of how aggressive the scope.
Where Historic Preservation review enters the picture is when your project includes any exterior change. Examples we encounter regularly: enlarging a window, relocating an exterior door, adding an exterior-vented hood that requires a new wall penetration, building a small addition or bump-out, or replacing a side-yard window with a different style. Any of these requires a Certificate of Appropriateness from the Historic Preservation Commission, which adds 4–8 weeks to the permit timeline and typically requires architectural drawings showing the proposed change in context.
For interior-only projects, the standard City of Boise permits apply: a building permit for structural work (wall removal, beam installation), an electrical permit for new circuits or panel work, a plumbing permit for fixture relocation or new water lines, and a mechanical permit for ducting or HVAC modifications. Permit fees for a typical mid-range project run several hundred to a few thousand dollars depending on scope. Processing times: electrical and plumbing permits are often same-day or next-day; building permits with structural drawings take 3–5 weeks for full review.
One North End-specific permit consideration: parking and right-of-way. Placing a dumpster on the street or parking a construction trailer at the curb requires a City of Boise right-of-way permit ($75–$250 depending on duration and footprint). Some North End streets have additional restrictions related to the historic neighborhood designation. Iron Crest pulls all required right-of-way permits as part of project setup.
Exterior paint material and color strategy for North End homes balances longevity, weather performance in Boise's high-UV/freeze-thaw climate, and architectural authenticity.

Paint product
Premium exterior paint is non-negotiable. Benjamin Moore Aura Exterior, Sherwin Williams Duration, or Sherwin Williams Emerald — all formulated for excellent UV resistance, mildew resistance, and color retention in Boise's high-altitude high-UV environment. Mid-grade exterior paints lose color quickly, chalk visibly, and require repainting in 5–6 years instead of 8–12. The premium-paint cost difference per house ($300–$600) is recovered many times over through extended life.
Color palette for Craftsman bungalows
Period-correct Craftsman color schemes use deep saturated body colors with contrasting trim and accent colors. Body options: forest green (BM Black Forest Green, SW Rosemary), deep red-brown (BM Caponata, SW Cabin Red), warm khaki (BM Manchester Tan, SW Sand Beach), navy (BM Hale Navy, SW Naval). Trim: warm cream or off-white (BM Cottage White, SW Antique White). Accents (doors, exposed rafter tails): brick red, deep green, or ochre. Avoid: stark white body, gray-on-gray schemes, modern monochromatic.
Color palette for Tudor and Colonial Revival
Tudor: cream or earth-tone stucco body with painted dark brown or black half-timbering, deep green or burgundy door, dark trim. Colonial Revival: warm white or cream body with painted shutters in deep blue or green, white trim, contrasting door color. Both eras tolerate richer, more formal palettes than Craftsman.
Surface prep — siding
Power wash to remove loose dirt and chalking. Scrape failing paint with hand scrapers (lead-safe procedures). Sand to feather edges between scraped and intact paint. Prime bare wood with oil-based or premium acrylic primer. Caulk gaps at trim-to-siding junctions, around windows, and at corner boards. Quality of prep determines paint job life.
Surface prep — trim and accents
More attention than body siding because of higher visibility. Scrape all failing paint, sand smooth, prime bare wood, fill nail holes and gaps, caulk all joints, sand priming coats smooth before finish. Trim takes the most time per square foot of any exterior painting work but is the most visible final surface.
Lead-safe practices
EPA RRP rules require: containment with poly sheeting on the ground around the work area to capture paint chips, dampened sanding to minimize airborne dust, HEPA vacuuming of work area at end of each day, posted warning signs, proper waste disposal of contaminated debris, and detailed cleanup verification. Adds 15–25% to total project cost compared to non-RRP work but is the legal and ethical requirement for any pre-1978 home.
Exterior painting prep in older North End homes routinely surfaces issues that affect cost and timeline. The items below are predictable patterns.
- •Rotted siding boards requiring replacement. Original wood siding 80–120 years old occasionally has rot at boards near grade, around drainage points, or at horizontal seams. Replacement of individual boards: $200–$500 per board. Larger areas of rot: priced as carpentry scope.
- •Failed caulk at every joint. Original caulk fails over decades. Comprehensive re-caulking of all trim joints, window perimeters, corner boards, and siding seams is part of restoration prep. Standard scope; substantial cases add $400–$1,500.
- •Soffit and fascia damage from gutters or weather. Older soffit and fascia surfaces sometimes have water damage from failing gutters or weather exposure. Repair before painting: $400–$2,500 depending on extent.
- •Window glazing failure. Original wood windows with deteriorated glazing putty around the panes need re-glazing before painting (otherwise the glazing failure continues to degrade the painted surface). Re-glazing per window: $80–$200.
- •Lead paint chipping and weathering. Pre-1978 painted surfaces with severe weathering have loose paint chips on the ground around the home. EPA RRP-compliant cleanup and ground containment add labor and disposal cost. Built into pricing for pre-1978 homes.
- •Porch column rot at base. Original Craftsman porch columns sometimes have rot at the base from water pooling. Repair or replacement: $400–$1,500 per column.
- •Exposed rafter tail damage or rot. Exposed rafter tails (signature Craftsman feature) sometimes have weather damage or rot at the exposed end. Repair: $80–$300 per rafter tail. Replacement: $200–$500 per tail.
- •Mildew or staining requiring chemical treatment before paint. North-facing or shaded elevations sometimes have mildew or algae growth. Treatment with mildewcide before priming and painting: $200–$600.
- •Historic Preservation Commission color review modifications. If property is within Historic District boundary, HPC has color guidance for compatibility. Iron Crest pre-meets with HPC for any pre-1940 home where color is changing dramatically. Modifications to selected colors based on HPC feedback may add design time but typically don't add cost.
Consultation and color planning (Week 1)
On-site walkthrough of the entire exterior — body, trim, soffits, accents, porch elements. Existing-condition photographs. Color consultation with large painted samples (12″ × 12″ on actual surfaces) to view in real lighting at different times of day. HPC pre-application discussion if applicable.
Estimate and HPC review (Weeks 1–6)
Detailed line-item estimate. If HPC review required, formal Certificate of Appropriateness application for color change (typically 6–10 week process). Material orders placed.
Mobilization and protection (Day 1 of work)
Plant and shrub protection. Walkway and driveway protection. Containment poly sheeting on ground around work area for lead-safe practices. Lift or scaffolding setup as needed.
Power washing (Day 1–2)
Comprehensive power wash to remove loose dirt, mildew, chalking, and any loose paint. Allow 24–48 hours for thorough drying before sanding.

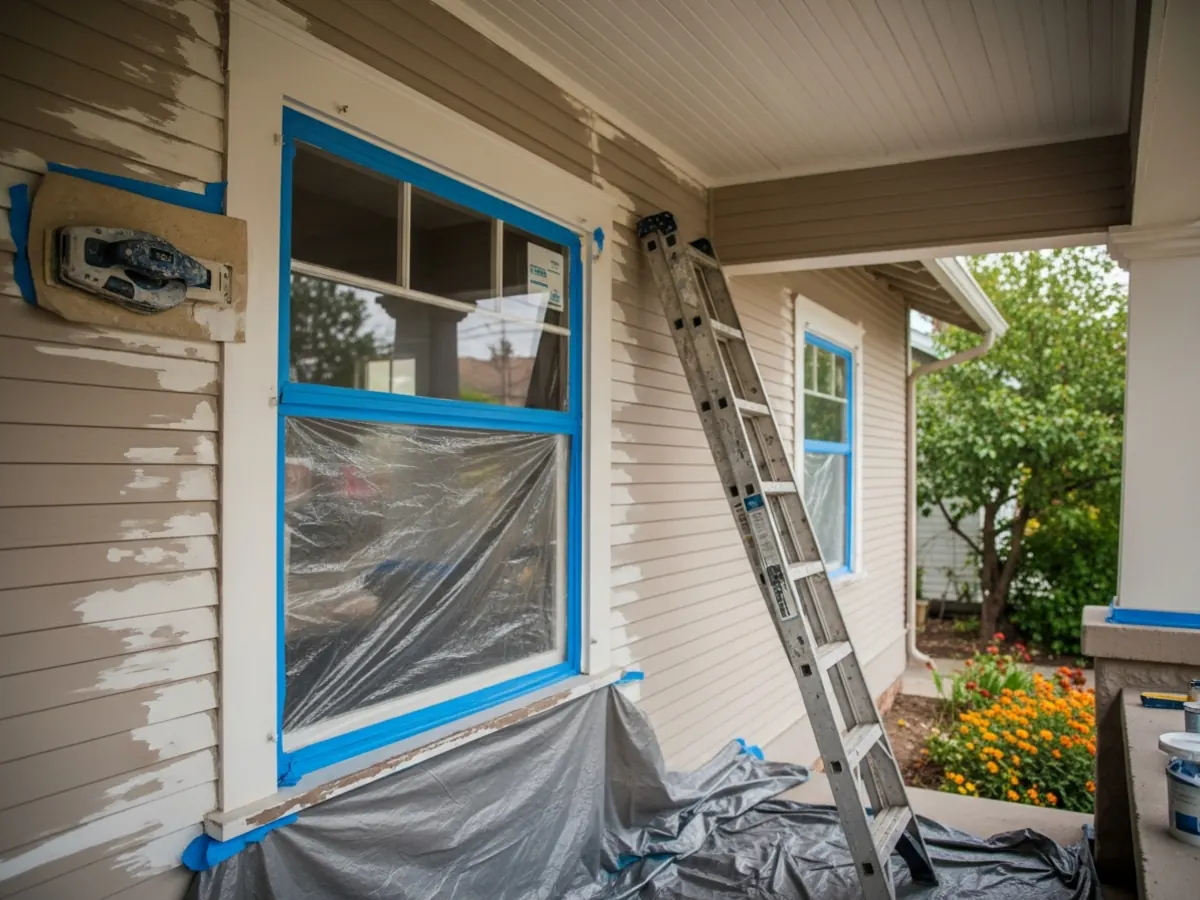

Scraping and sanding (Days 3–8)
The longest single activity. Hand scraping of failing paint with lead-safe procedures. Power sanding (with HEPA collection) where appropriate. Surface preparation to provide proper substrate for paint.
Priming and caulking (Days 8–12)
Prime all bare wood with oil-based or premium acrylic primer. Caulk all joints, trim seams, and gaps. Repair any rot or damage discovered during prep. Replace damaged boards or trim pieces.
First finish coat — body (Days 12–15)
First coat of body color across all siding. Consistent thickness, proper temperature conditions (50°F+ ambient, dry weather forecast for 24 hours after).
Second finish coat — body (Days 15–18)
Second coat for full coverage and color depth. This is the final body surface.
Trim, accents, doors, walkthrough (Days 18–25)
Trim painting in coordinated color (multiple coats for smooth finish). Door painting (typically off-hardware for clean finish). Final touch-ups. Walkthrough with you. Punch-list addressed within 1 week. 7-year workmanship warranty begins.
Exterior painting on older North End homes is a different category from same-day power-wash-and-spray work that's common in suburban developments. The prep discipline, lead-safe practices, and material quality determine whether the paint lasts 4 years or 12.

- City of Boise Historic Preservation Commission — Design review information, district maps, and Certificate of Appropriateness application.
- City of Boise Planning & Development Services — Building, electrical, plumbing, and mechanical permits. Online portal and in-person plan check.
- Idaho DEQ Asbestos Program — Testing and abatement requirements for pre-1980 homes.
- EPA Lead Renovation, Repair and Painting (RRP) Program — Required certification and work practices for renovation in lead-paint homes.
- Preservation Idaho — Statewide nonprofit advocating for historic preservation. Resources and educational events.
Why does exterior painting cost more on an older North End home?
EPA RRP-required lead-safe practices add 15–25% to project cost on pre-1978 homes. Surface prep is more extensive — original wood siding 80–120 years old requires careful scraping, sanding, priming, and rot repair that newer siding doesn't need. Trim work is more complex (Craftsman millwork has more profiles and edges than modern trim). Quality matters more — premium paint and proper prep are the difference between an 8–12 year paint life and a 3–5 year paint life. Cutting these corners produces a paint job that fails embarrassingly soon.
Do I need Historic Preservation Commission approval to change my exterior color?
If your property is within the North End Historic District boundary, the HPC has color guidance for compatibility with the historic character of the neighborhood. Significant color changes (e.g., body color from cream to navy) typically warrant a Certificate of Appropriateness review; minor refreshes of similar colors usually don't. Iron Crest pre-meets with HPC staff before formal application to identify any concerns. Adds 6–10 weeks to project timeline if formal review required.
How long should an exterior paint job last on a North End Craftsman?
8–12 years on properly prepped, premium-painted surfaces. Properly prepped means: comprehensive scraping of failing paint, sanding to feather edges, priming bare wood, caulking all joints, and applying two coats of premium paint. Premium paint means Benjamin Moore Aura Exterior, Sherwin Williams Duration, or equivalent. Cheap or rushed paint jobs on North End homes fail in 3–5 years (peeling, chalking, fading) and you end up paying twice. The premium investment pays back through extended life.
What's the right color scheme for a Craftsman bungalow in the North End?
Period-correct Craftsman color schemes use deep saturated body colors with contrasting trim and accent colors. Common North End palettes: forest green body with cream trim and brick-red accents; deep red-brown body with warm cream trim and dark green door; navy body with warm cream trim and bright color door; warm khaki body with white trim and ochre accents. Iron Crest provides color consultation with painted samples on your specific home so you can see options in your specific lighting and context.
Can I have my exterior painted while I live in the home?
Yes, with planning. Exterior painting is inherently low-impact on indoor life — work happens outside, doors and windows are typically usable except briefly during direct adjacent painting. Some scheduling consideration around bedrooms (avoid painting outside bedroom windows during early morning) and home offices (avoid painting outside office windows during work hours where possible). We discuss your routine and accommodate accordingly.
Do you do soft washing instead of pressure washing?
We use medium-pressure power washing (1,500–2,500 PSI) for most North End surfaces — soft washing alone (low pressure with chemical solution) doesn't adequately remove failing paint and chalking. Power washing on original wood siding requires careful technique to avoid driving water into joints or damaging surfaces. We adjust pressure and technique to substrate condition.
What about painting in winter or shoulder seasons?
Boise's exterior painting season is roughly April through October — temperatures need to be 50°F+ during application and overnight, with no rain forecast 24 hours after each coat. Late October through March is generally too cold or unpredictable. Booking lead times stretch to 4–8 weeks during peak season (May through September). Off-season (April or October) often has better scheduling availability.
What about wood rot or damage discovered during prep?
We assess obvious damage during the consultation walkthrough and include reasonable repair scope in the contract. Hidden rot discovered during scraping is addressed via change order priced at our standard hourly rate plus materials. Substantial rot (multiple rotted boards, structural damage) sometimes warrants pausing the paint project to do dedicated repair work before continuing. We flag concerns immediately when discovered and discuss options before continuing.
Ready to start your North End exterior painting project?
Free in-home consultation, honest contingency-based budgeting, and the experience these older Boise homes require. Iron Crest Remodel — Idaho RCE #6681702, EPA RRP lead-safe certified, $2M general liability, 5-year workmanship warranty.
Get Your Free Estimate
