Siding Installation Timeline in Boise
A realistic, day-by-day breakdown of how long siding installation takes in Boise and the Treasure Valley. From scaffold setup through final caulking, know what to expect at every stage.
Siding installation timelines vary significantly based on home size, the number of stories, siding material, and whether additional work like window replacement is included. Here is what to expect for each scope in the Boise market.
Partial Re-Side (1 Wall / Accent Area)
2 - 4 Days
Targeted replacement of a single wall face, gable end, or accent area. Common for addressing storm damage on one elevation, replacing deteriorated siding around a bay window, or adding a contrasting material (board-and-batten, cedar shakes, or stone veneer) to a front-facing accent wall. Includes removal of existing siding on the affected area, sheathing inspection, house wrap repair if needed, new siding installation, and caulking. Scaffolding is typically limited to a single setup.
Standard Home (1,500 - 2,500 Sq Ft)
1 - 2 Weeks
Complete siding replacement on a typical single-story or split-level Boise home. This is the most common project scope we handle in neighborhoods like Southeast Boise, West Bench, and North End. Includes full removal of old siding on all elevations, sheathing inspection and repair, new weather-resistive barrier (house wrap), siding installation, window and door trim, soffit, fascia, and all caulking and touch-up work. A crew of 3 to 4 installers works systematically around the house, completing one elevation before moving to the next.
Large / Multi-Story (2,500 - 4,000+ Sq Ft)
2 - 3 Weeks
Larger homes and two-story or three-story structures require more material, more scaffolding setups, and more time for safe high-elevation work. Homes in Eagle, Meridian, and the Boise Foothills frequently fall in this category. Multi-story scaffolding must be erected, repositioned around the home, and eventually disassembled. Second and third-story work is inherently slower due to material lifting, safety protocols, and the difficulty of cutting and fitting siding at height. Complex rooflines, multiple dormers, and extensive trim work add additional time.
Siding + Windows Bundle
3 - 5 Weeks
Combining siding replacement with window replacement is the most comprehensive exterior envelope upgrade. This is particularly common for 1970s and 1980s-era Boise homes where both the original aluminum or T1-11 siding and single-pane windows have reached end of life. The sequencing is strategic: old siding is removed first, then windows are installed with proper flashing that integrates into the weather-resistive barrier, then new siding is installed around the windows. This approach delivers superior waterproofing compared to separate projects and saves significant labor cost.
Here is a detailed look at what happens each day during a standard siding installation on a typical 1,500 to 2,500 square foot Boise home. This breakdown assumes fiber cement or engineered wood siding and a crew of 3 to 4 experienced installers.
Days 1 - 2: Scaffold Setup, Old Siding Removal & Sheathing Inspection
2 DaysThe project begins with site preparation and scaffolding erection. For single-story homes, pump jacks or ladder jacks may suffice. Two-story homes require frame scaffolding erected to code with guardrails and toe boards. Landscaping adjacent to the home is protected with drop cloths and plywood sheeting. Once scaffolding is secure, the crew begins stripping the old siding, working from top to bottom on each elevation to maintain structural stability. Old nails are pulled, and the underlying sheathing is fully exposed for inspection.
- Scaffolding erection and safety inspection
- Landscape and hardscape protection
- Old siding removal (all elevations)
- Sheathing condition assessment and documentation
Days 3 - 4: Sheathing Repair & House Wrap / WRB Installation
2 DaysWith the old siding removed, any damaged or deteriorated sheathing is cut out and replaced. In Boise, the most common sheathing issues we encounter are water damage around windows where flashing was improperly installed, rot at the base of walls near grade level where soil contact or splashback has caused moisture intrusion, and OSB delamination from long-term moisture exposure behind failed caulk joints. Once all sheathing is sound, the weather-resistive barrier (WRB) is installed. We use a premium house wrap product, applied from bottom to top with 6-inch horizontal overlaps and 12-inch vertical overlaps, sealed at all seams with manufacturer-specified tape. Window and door openings receive self-adhering flashing membrane integrated with the house wrap in a shingle-lap pattern to direct water outward.
- Damaged sheathing section replacement

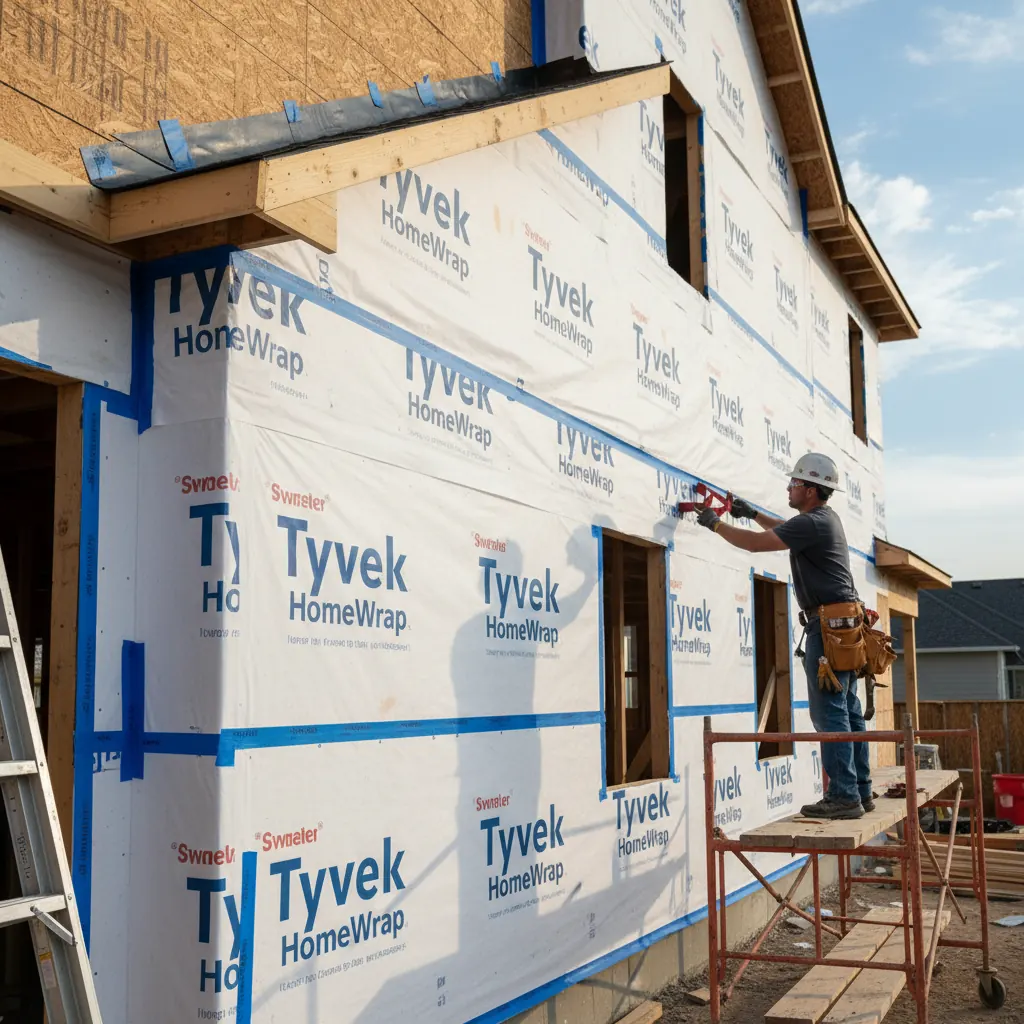

- Full house wrap application (bottom to top)
- Window and door flashing integration
- Seam taping and penetration sealing

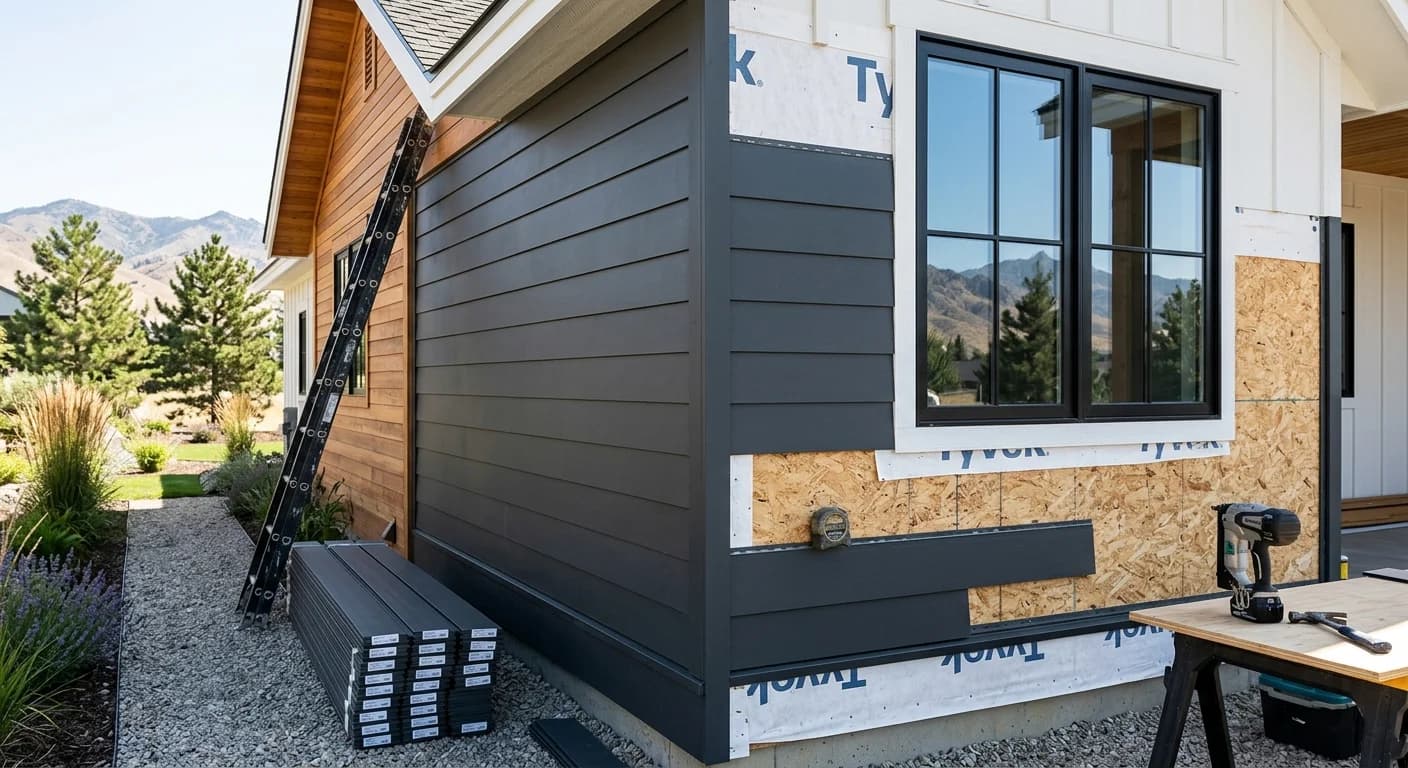

Days 5 - 8: Siding Installation (Bottom to Top)
4 DaysThis is the core of the project. Siding is installed from the bottom of each wall upward, starting with a starter strip that establishes the first course level line. Each subsequent course locks into or overlaps the one below it. For fiber cement (James Hardie is the most common brand in the Boise market), each plank is blind-nailed through the top edge into studs at 16-inch on-center intervals. Butt joints are staggered to avoid lining up vertically. Cuts around electrical meters, hose bibs, HVAC penetrations, dryer vents, and light fixtures require precision fitting. The crew works one elevation at a time, completing each wall face before repositioning scaffolding to the next side.
Vinyl siding follows a similar bottom-to-top sequence but uses a locking channel system rather than nailing. Panels are hung loosely to allow for thermal expansion and contraction — a critical detail in Boise where summer temperatures regularly exceed 100 degrees and winter lows drop well below freezing. Engineered wood siding (LP SmartSide) is face-nailed and caulked at every butt joint, which adds time compared to vinyl but provides a more substantial, paintable exterior.
- Starter strip installation and level line
- Course-by-course siding installation
- Precision cuts around penetrations
- Scaffold repositioning between elevations

Days 9 - 10: Trim, Soffit & Fascia
2 DaysTrim work is what gives a siding job its finished, professional appearance. Window and door casings are installed, providing a clean frame around each opening. Corner boards are applied at inside and outside corners. Frieze boards cap the top of each wall at the soffit junction. If soffit and fascia are part of the project scope, old material is removed and replaced with vented aluminum or fiber cement soffit panels and wrapped fascia boards. Proper soffit ventilation is critical in Boise's climate to prevent moisture accumulation in the attic space, particularly during the dramatic temperature swings between hot summer days and cold winter nights.
- Window and door trim/casing installation
- Corner board installation
- Soffit panel replacement (vented)
- Fascia board wrapping or replacement
Days 11 - 12: Caulking, Touch-Up Paint & Cleanup
2 DaysThe final phase is all about details and weatherproofing. Every butt joint, trim junction, window and door perimeter, and penetration point receives a bead of high-quality, paintable, exterior-grade sealant. For fiber cement and engineered wood siding, exposed cut edges and nail heads are primed and touch-up painted to match the factory finish. Any areas where the factory color coat was scratched during handling or installation are addressed. The crew conducts a full perimeter walkthrough, checking every course for proper alignment, secure fastening, and complete caulking.
Site cleanup is thorough: scaffolding is disassembled and removed, all old siding debris is loaded and hauled away, nails and fasteners are collected with a rolling magnet, landscape protection is removed, and the yard is restored to pre-project condition. A final walkthrough with the homeowner confirms satisfaction before the project is officially closed out.
- Comprehensive caulking of all joints and gaps
- Touch-up paint on cut edges and nail heads
- Scaffolding teardown and removal
- Debris hauling, nail sweep, and yard restoration
Boise's semi-arid climate with hot, dry summers and cold winters creates a defined seasonal window for exterior siding work. Understanding these conditions helps you schedule your project for the best results and fewest weather delays.
Prime Season: April - October
The best months for siding installation in Boise are April through October. Daytime temperatures consistently exceed 50 degrees, precipitation is minimal (Boise averages only 12 inches of rain per year, with the driest stretch from June through September), and extended daylight hours allow for productive 8 to 10 hour workdays. Late April through June and September through mid-October are the sweet spot — warm enough for all materials and adhesives but not so hot that crews face heat exhaustion risks.
Fiber Cement Temperature Requirements
James Hardie and other fiber cement manufacturers require ambient temperatures above 40 degrees Fahrenheit during installation. Below this threshold, the material becomes more prone to chipping during cutting and nailing. In Boise, this typically limits reliable fiber cement installation to mid-March through mid-November, though early morning temperatures in spring and fall may require delaying the start of cutting until mid-morning. We monitor forecasts daily and adjust start times accordingly.
Caulk & Paint Adhesion Requirements
Exterior caulk requires temperatures above 40 degrees (ideally above 50 degrees) for proper curing. Paint and primer on cut edges need at least 50 degrees and falling dew points to achieve full adhesion. In Boise's dry climate, paint dries quickly — sometimes too quickly in July and August heat. During peak summer, we apply touch-up paint in the early morning or late afternoon to avoid flash drying, which can cause poor adhesion. We schedule caulking and painting phases for days with forecasted highs between 55 and 85 degrees whenever possible.
Smoke Season Impact (August - September)
Boise's wildfire smoke season, typically August through mid-September, can impact exterior painting and caulking. Heavy smoke events reduce air quality to unhealthy levels, making outdoor work unsafe for extended periods. Smoke particles can also settle on wet paint and caulk, compromising finish quality. Siding installation itself (nailing, cutting, fastening) can continue during moderate smoke conditions, but final caulking and touch-up painting may be delayed until air quality improves. We build 2 to 3 contingency days into summer project schedules to account for potential smoke delays.
Spring Rain Patterns
April and May are Boise's wettest months, with occasional multi-day rain events. While siding installation can proceed in light drizzle, sustained rain halts work for several reasons: wet house wrap seams do not tape properly, fiber cement absorbs moisture that can affect paint adhesion, and wet scaffolding surfaces create slip hazards. We monitor 10-day forecasts when scheduling spring starts and avoid beginning the house wrap phase when rain is predicted within 48 hours. A typical spring project may lose 1 to 3 days to weather over a two-week span.
Boise Summer Heat Considerations
July and August in Boise regularly see temperatures above 100 degrees. Extreme heat affects crew productivity, requires more frequent hydration breaks, and can cause vinyl siding to become too pliable for precise installation. For summer projects, crews start at 6:00 or 6:30 AM and work through the early afternoon, avoiding the hottest 3 to 4 hours of the day. This adjusted schedule may extend the overall project by 1 to 2 days but ensures quality installation and crew safety. South-facing and west-facing elevations in direct afternoon sun are typically completed first in the morning hours.
Even with careful planning, certain factors can extend your siding project beyond the estimated timeline. Here are the most common causes of delays we encounter in the Boise market and how we mitigate each one.
Hidden Sheathing Damage
This is the number one cause of siding delays in Boise. Old siding hides what is underneath it, and until it is removed, the true condition of the sheathing is unknown. Approximately 20 to 30 percent of re-siding projects in the Boise area reveal some level of sheathing damage — OSB that has delaminated from moisture intrusion, plywood with fungal decay, or original board sheathing with dry rot. The most common problem areas are below windows where flashing was missing or improperly installed, at the base of walls where soil has been graded too close to the siding, and around hose bibs and outdoor faucets. Depending on severity, sheathing repair can add 1 to 5 days to the project timeline.
Weather Delays
Unlike interior remodeling, siding is fully exposed to the elements. Rain, snow, sustained wind above 25 mph, and extreme temperatures can all halt progress. Boise's spring thunderstorms can appear quickly and dump significant moisture in a short period. Wind is a frequent disruptor in the Treasure Valley — particularly along the Bench and in exposed foothills locations where gusts can exceed 40 mph. High winds make scaffolding work unsafe and can catch siding panels like sails during handling. We build weather contingency into every estimate: 1 to 2 days for summer projects, 2 to 4 days for spring and fall projects.
Material Delivery Delays
Siding materials are ordered from regional distributors and manufacturers. Standard colors and profiles of James Hardie, LP SmartSide, and major vinyl brands are typically available within 1 to 2 weeks. Custom colors, specialty profiles (board-and-batten, shake-style, vertical panel), and less common products may require 3 to 6 weeks. We order materials as soon as the contract is signed and confirm delivery dates before scheduling crews. Occasionally, distributor backorders or shipping delays from out-of-state manufacturing facilities extend delivery windows by 1 to 2 weeks. We maintain relationships with multiple distributors in the Boise area to source backup inventory when needed.
Window Integration Sequencing
When siding and window replacement are bundled, the project becomes sequentially dependent: old siding must come off before windows can be properly installed and flashed, and new siding cannot go on until windows are in place and flashed. If window delivery is delayed — custom sizes, specialty glass (Low-E, triple pane, impact-rated), or unique configurations can have lead times of 4 to 8 weeks — the entire siding project stalls. We mitigate this by ordering windows at the earliest possible date, confirming delivery schedules weekly, and in some cases staging siding work on elevations without window changes while waiting for window delivery on affected walls.
Permit & HOA Approval Delays
While many siding replacement projects in Boise do not require a building permit (like-for-like replacement is typically exempt), projects that change siding material type, add insulation, or modify the building envelope may require permit review. Homes in HOA communities — common in Eagle, parts of Meridian, and newer Boise subdivisions — must submit architectural review applications that include color samples, material specifications, and sometimes elevation drawings. HOA review can take 2 to 6 weeks depending on the community's review cycle and meeting schedule. We recommend submitting HOA applications at least 6 weeks before the desired start date.
Lead Paint & Asbestos Abatement
Homes built before 1978 may have lead-based paint on existing siding or trim. Homes built before 1980 may have asbestos-containing materials in siding (particularly cement-asbestos shingles common in mid-century Boise homes), caulk, or putty. Federal EPA RRP (Renovation, Repair, and Painting) rules require certified lead-safe work practices, which add time and cost to the removal phase. Asbestos-containing siding requires licensed abatement or encapsulation. Testing takes 1 to 3 days for lab results. If abatement is needed, it can add 3 to 7 days and must be completed before new siding work begins.
Delays are not inevitable. Our project management approach is designed to minimize schedule risk at every phase. Here is how we protect your timeline.
Pre-Construction Planning
- Materials are ordered within 48 hours of contract signing. We confirm delivery dates before scheduling the crew start date, ensuring materials are on-site before day one.
- Pre-project site assessment identifies potential issues: proximity to overhead power lines (may require utility coordination), steep grades that affect scaffolding setup, and trees or structures that limit equipment access.
- For homes built before 1978, lead paint testing is completed during the estimate phase so results are available before the project starts. No surprises on demolition day.
- HOA applications are submitted during the material ordering phase, running in parallel rather than in sequence. By the time materials arrive, approval is typically in hand.
- Weather forecasting is monitored starting two weeks before the scheduled start date. If a major weather event is predicted for the first week, we proactively reschedule to avoid a stalled start.
During Construction
- Dedicated crew assignment: the same team works your project from start to finish. No crew-sharing across multiple jobs, which eliminates the most common cause of contractor-driven delays in the Boise market.
- Daily progress photos and updates sent to the homeowner. You always know where the project stands relative to the schedule.
- Material buffer: we order 10 to 15 percent overage on siding to account for cuts, waste, and the occasional damaged piece. Running short and waiting for a reorder is a preventable delay.
- Sheathing repair materials (OSB, plywood, flashing) are kept on the truck as standard inventory. When hidden damage is found, repair begins immediately rather than waiting for a material run.
- Weather-day protocol: if rain or wind halts work, we protect exposed areas with tarps and plastic sheeting, and reschedule the lost day to the next available window — often the following day.
Common questions about siding installation timelines and scheduling in the Boise area.
How long does it take to re-side a house in Boise?
A standard Boise home between 1,500 and 2,500 square feet typically takes 1 to 2 weeks for complete siding replacement, including old siding removal, sheathing inspection, house wrap installation, new siding, and trim work. Smaller projects like a single-wall accent re-side can be finished in 2 to 4 days. Larger or multi-story homes in the 2,500 to 4,000+ square foot range generally require 2 to 3 weeks. These timelines assume favorable weather and no major sheathing repairs.
What is the best time of year to install siding in Boise?
The ideal siding installation window in Boise runs from mid-April through mid-October. Fiber cement siding requires ambient temperatures above 40 degrees Fahrenheit for proper cutting and installation. Caulk and paint need temperatures above 50 degrees for correct adhesion and curing. Summer months (June through August) offer the most predictable conditions, though Boise wildfire smoke in August and September can occasionally delay exterior painting. Spring and early fall provide comfortable working temperatures with fewer scheduling conflicts.
Can siding be installed in winter in Boise?
Winter siding installation in Boise is possible but comes with significant limitations. Vinyl siding becomes brittle below 40 degrees and is prone to cracking during cutting and nailing. Fiber cement manufacturers void warranties if installed below their minimum temperature thresholds. Caulk and paint fail to cure properly in cold temperatures. If winter installation is unavoidable, we schedule work during warm spells (above 45 degrees), use cold-weather caulk formulations, and plan for extended cure times. Expect the project to take 30 to 50 percent longer due to shorter workdays and weather interruptions.
Does replacing windows at the same time affect the siding timeline?
Yes, bundling window replacement with siding installation adds 1 to 2 weeks to the overall project timeline but is significantly more cost-effective than doing them separately. Windows are best installed after old siding is removed and before new siding goes on, which allows proper flashing integration with the weather-resistive barrier. This sequencing eliminates the need to remove and reinstall siding around windows later. We coordinate window delivery schedules to align with the siding removal phase to avoid idle time on site.
What causes the most siding installation delays in Boise?
The most common delay we encounter in Boise is hidden sheathing damage discovered after removing old siding. Roughly 20 to 30 percent of re-siding projects in older Boise neighborhoods reveal some level of OSB or plywood deterioration, particularly around windows, hose bibs, and areas where original flashing was inadequate. Repairing or replacing damaged sheathing sections can add 1 to 3 days per affected wall. Material delivery delays and multi-day rain events during spring are the next most frequent causes of schedule extensions.
